Microsoft Project effectively records task durations in hours and the value of the duration in days is calculated using the parameter entered in the Hours per day: field in the File, Options, Schedule tab, Calendar options for this project: section. It is VERY IMPORTANT that all users understand that the durations in days are calculated using ONLY the one parameter and this parameter is used with EVERY calendar. This makes Microsoft Project difficult to use when calendars with a different number of hours per day are being used.

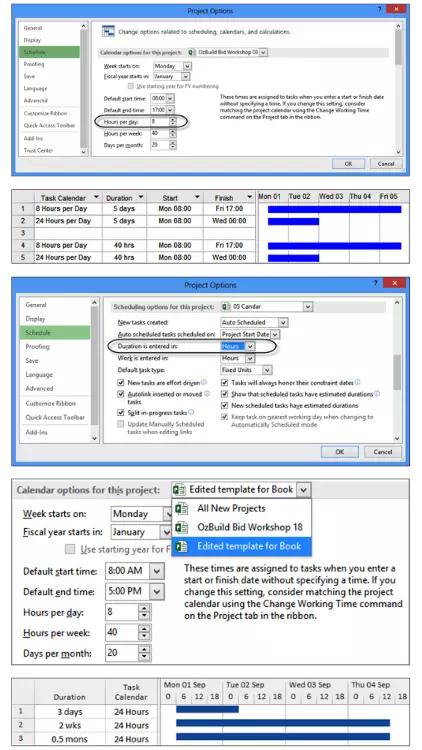

For example, the Options form below shows the Hours per day: as “8”. Therefore, when tasks are:
The picture on the right shows:
It is STRONGLY RECOMMENDED that inexperienced users avoid changing calendar start and finish times or assigning calendars with different numbers of hours per day whenever possible.
To display the duration in hours:
The File, Options, Schedule, Calendar options for this project options are explained in more detail below:
The title of these options does not clearly indicate their functionality. Options for Hours per day:, Hours per week: and Days per month: SHOULD be understood, especially if multiple Task calendars are used.
It is essential to match both the Default start time: and Default end time: with your project calendar’s normal start and finish times. For example, when the Default start time: is set earlier than the calendar normal start time, a task set with a constraint without a time will appear to finish one day later than scheduled. Therefore a one-day task will span two days and a two-day task, three days.
The following options need to be understood as they affect how summary durations are displayed. NOTE: THESE OPTIONS ARE IMPORTANT. Microsoft Project effectively calculates in hours. Task durations may be displayed in days, weeks and months. These summarized durations are calculated based on the parameters set in Options, Calendar. These options work fine when all project calendars are based on the same number of work hours per day. When tasks are scheduled with calendars that do not conform to the Options, Calendar settings (e.g., when the Options, Calendar settings are set for 8 hours per day and there are tasks scheduled on a 24-hour per day calendar), the results often create confusion for new users.
Hours per day: – This setting is used to convert the duration in hours to the displayed value of the duration in days. For example, a task entered as a 3-day duration and assigned a 24-hour per day calendar will be displayed in the bar chart as 1-day elapsed duration. This bar chart duration is 1/3 of the duration value since each day is an 8-hour equivalent on a 24-hour calendar and the output is not logical. See Task 1 on the right.
Hours per week: – This setting is used to convert the calendar hours to the displayed duration in weeks. For example, a task entered as 2 weeks (10 working days) and assigned a 24-hour per day calendar is displayed with a 3-day and 6-hour duration in the bar chart. This is 1/3 of the “normal” duration and again not logical. See Task 2 on the right.
Days per month: – This option is used to convert the displayed task duration from days to months. For example, a 0.5-month task (10 working days) on a 24-hour per day calendar is displayed as a 3-day and 6-hour duration in the bar chart and again is not logical. See Task 3 on the right.
All the durations displayed in the picture are misleading. It is important that this situation be avoided.
Other scheduling software also exhibits the time conversion problem when using multi-calendars. This display can lead to a great deal of confusion. To avoid confusion when using multi-calendars, it is suggested that you only display durations in hours.
Should you wish to display your times in 24-hour format, e.g. 17:00hrs instead of 5:00pm then:
Earn 25% commission when your network purchase Uplyrn courses or subscribe to our annual membership. It’s the best thing ever. Next to learning, of course.
There are some workable options to ensure that the durations in days are calculated and/or displayed correctly:

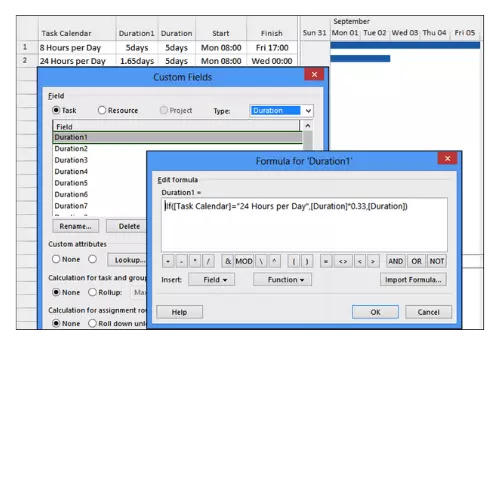

To create the formula displayed above:
To see more explanations like this, then consider buying my Project Management: Plan and Control with Microsoft Project online course.
