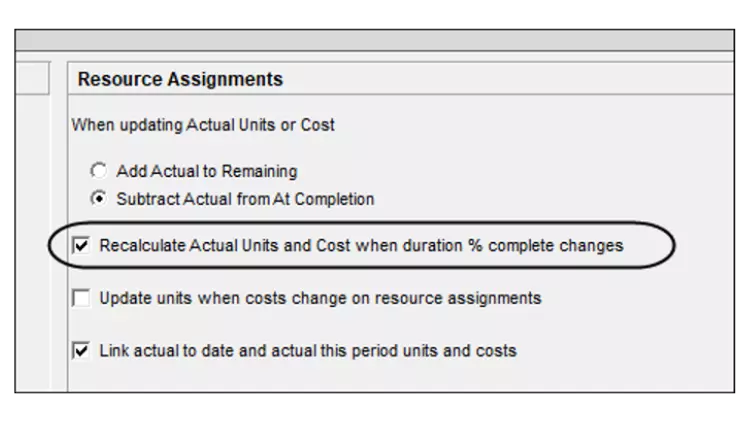

If you have the Recalculate Actual Units and Costs when duration % complete changes checked then the Remaining Units and Costs should be recalculated when a task is set as In Progress and the Remaining Duration is less than the Original Duration.
What I have found in Version 20, but other versions may calculate differently:
Earn 25% commission when your network purchase Uplyrn courses or subscribe to our annual membership. It’s the best thing ever. Next to learning, of course.
So, what is the solution, simple, select the menu item Tools, Recalculate Assignment Costs:
Before Updating

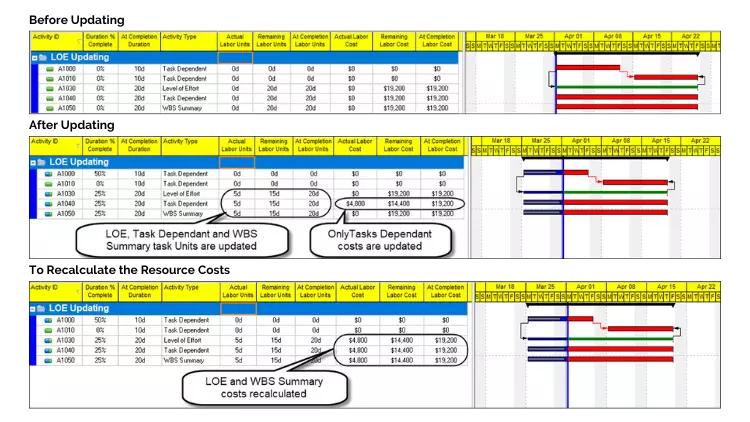

I have assigned one resource to the three tasks, a LOE, Task Dependent and WBS Summary.
After Updating
The Task Dependent task units and costs are updated as expected, but the WBS Summary and LOE tasks units are updated but the WBS Summary and LOE tasks costs are not updated.
To Recalculate the Resource Costs
Now select Tools, Recalculate Assignment Cost and the LOE and WBS Summary Costs are recalculated.
Remember your activity Duration Type will affect your calculation of the Remaining Units and Costs.
If you have changed your resource rates then the new resource rate will be applied to the resource costs.
If you want to learn more about Planning and Control with Microsoft Project, please check out my online course here.
