Primavera has many more date fields for the current schedule than other products and some do not display as expected.
This document explains how these date fields calculate and indicates which to avoid.
After you understand these date fields, you should look again at the Bar Timescale options in the Bars form and it will be easier for you to understand how the bar formatting works.
To help understand the issues of some P6 date fields it is beneficial to understand how P6 calculates the Critical Path.
Basically, P6 calculates the forward and backward pass on all activities, including complete activities, using the Remaining Duration and the Data Date. This explains why completed activities have:
After you understand these date fields, you should look again at the Bar Timescale options in the Bars form and it will be easier for you to understand how the bar formatting works.
NOTE: The Hint Help is very useful to understand how fields are calculated.

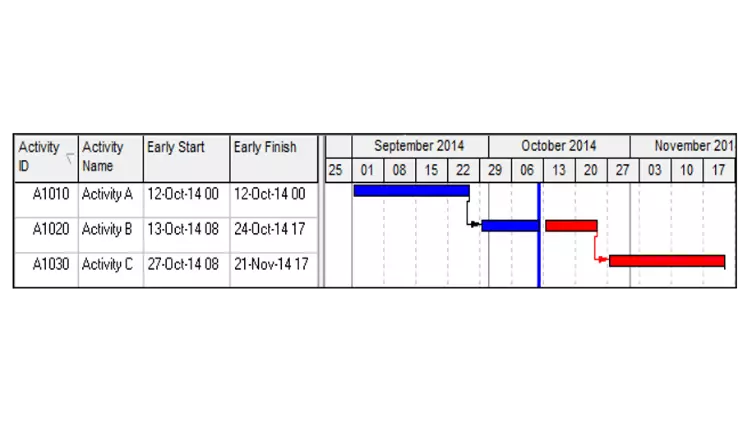

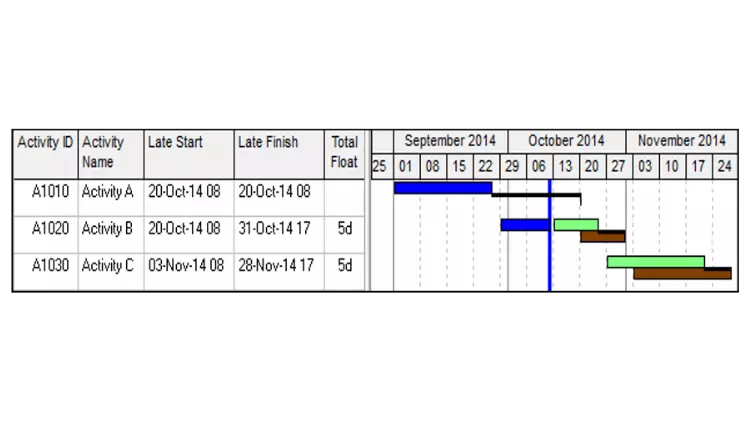

These are always the earliest dates that un-started activities or the incomplete portions of in progress activities may start or finish based on calendars, relationships and constraints.
NOTE: Look carefully at the activity A1010 Early Start and Early Finish dates and then look at the Actual Start and Actual Finish of the bar; they are very different.
The Early Start and Early Finish dates of completed activities and Early Start of in progress activities is not displayed in other software in this way and often leads to confusion when converting from other software.
NOTE: It is recommended that these are never displayed on an in progress schedule.
Earn 25% commission when your network purchase Uplyrn courses or subscribe to our annual membership. It’s the best thing ever. Next to learning, of course.
NOTE: It is recommended these are never displayed on an in progress schedule.

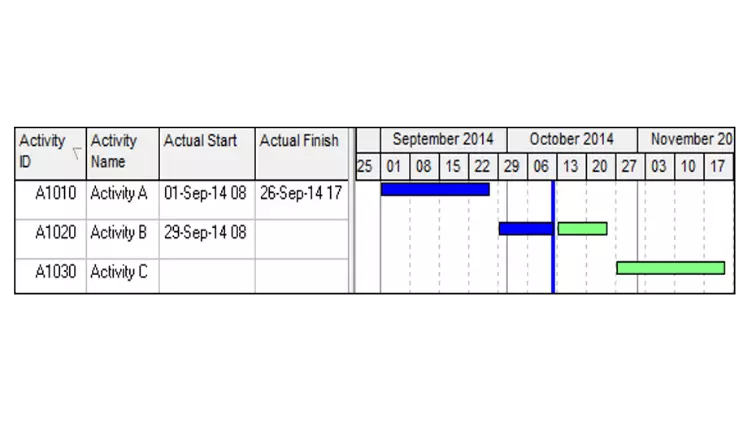

These dates are manually applied, representing when an activity started or finished, and override constraints and relationships. These dates should be set in the past in relation to the Data Date.
Actual dates should never change after they are assigned, but both the Apply Actuals, when activities are set to Auto Compute Actuals, and Update Progress functions may change Actual dates.
NOTE: Both these functions must be used with extreme caution.
The Planned Finish is calculated from the Planned Start plus the Original Duration. The Original Duration is labeled Planned Duration in some Industry Versions. These fields are always linked, therefore:

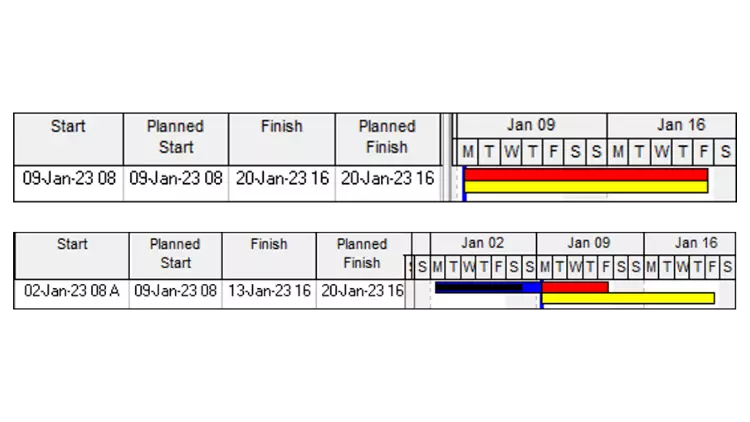

In the pictures on the right, the Planned Dates are displayed in the lower bar and when an activity has NOT started:
NOTE: Planned dates become unlinked from the Start and Finish when Link Budget and At Completion for started activities is unchecked. It is recommended you do not do this.
When an activity is marked as in progress:

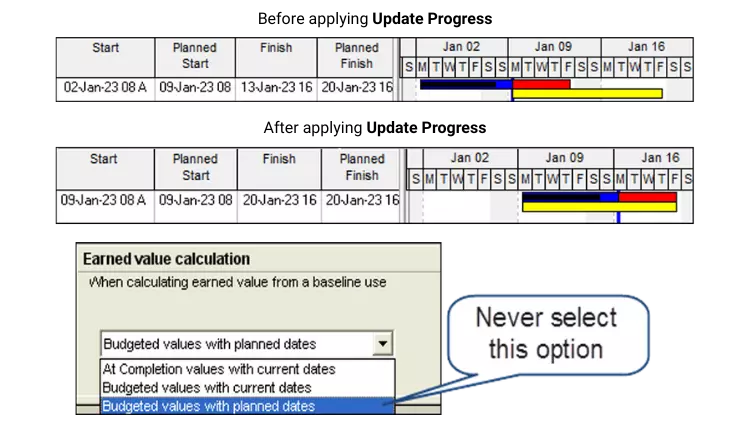

NOTE: At this point the Planned Dates may contain irrelevant information, as they may not represent the schedule was planned, last period or this period, or match a baseline. This effectively contain irrelevant information and MUST NEVER EVER be displayed.
When an activity is complete:
This is one of the most important paragraphs in this book and you must be certain that you understand the Planned Dates and how to avoid the issues associated with them.
Thus, in this situation, which is very common, the Planned Dates are now holding irrelevant dates that should never be displayed or used for any purpose.
Unfortunately, the Planned Dates are used by default in several places and Database Administrators and users must be aware of where they are used and how to avoid displaying them.
NOTE: Ensure you NEVER EVER use the Update Progress function on a schedule that has been progressed, otherwise Actual Start dates and Early Finish dates of in progress activities will be changed to the Planned Date values without warning.
Some schedulers run a Global Change to set the planned dates to the Start and Finish dates before running Update Progress, but this has two issues:
