When you create a new project in P6 the default Percent Complete Type is Duration. Is this the best option and do you understand the difference between Duration, Physical and Units Percent Complete?
It is my opinion this should always be changed to Physical for several reasons outlined in the recommendations paragraph at the end of this article.
The Percent Complete type should be understood if it is intended to update (status or progress) a schedule. In Primavera this option may be set for each activity individually and the default for new activities is set in the Percent Complete Type drop down box. Primavera has many Activity Percent Complete fields that may be displayed in columns and we will discuss four of them now:
Activity % Complete, displayed on the % Complete Bar, may be linked to only one of the three % Complete following three fields:
There are three Percent Complete options; each new activity is assigned the project default Percent Complete Type and then this may be edited for each activity as required.
Therefore, if the option of Physical % Complete is selected for an activity then the Activity % Complete and the Physical % Complete are linked and a change to one will change the other.
Earn 25% commission when your network purchase Uplyrn courses or subscribe to our annual membership. It’s the best thing ever. Next to learning, of course.

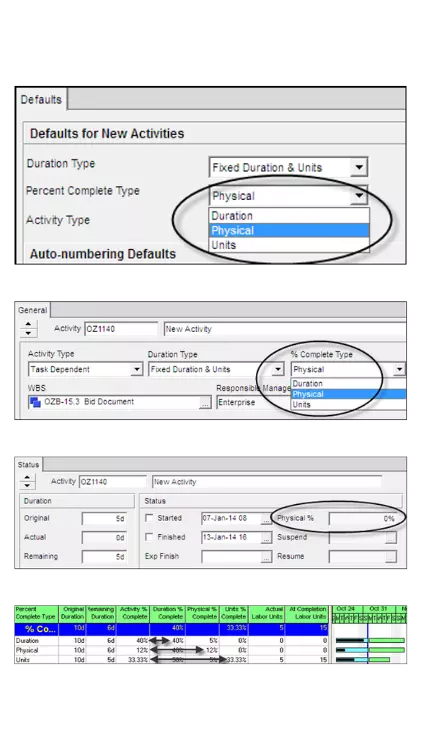

A project default Percent Complete Type is assigned in the Defaults tab of the Projects Window to each new activity created in a project. This may be changed at any time and only affects new activities created from that time onward.
After an activity has been created, the Percent Complete Type may be changed in the General tab of the Activities Window.
The Activity Percent Complete may be updated in the Status tab of the Activities Window where the Percent Complete Type is also displayed.
Each Percent Complete Type has its own data column and is always calculated. There is also an Activity % Complete column which is linked to and displays the value from the Percent Complete Type column that has been assigned to the activity. See the picture on the right.
The Activity % Complete is in turn linked to the Bar Percent Complete, therefore in effect the Percent Complete Type determines the way the percent complete is displayed on the bars.

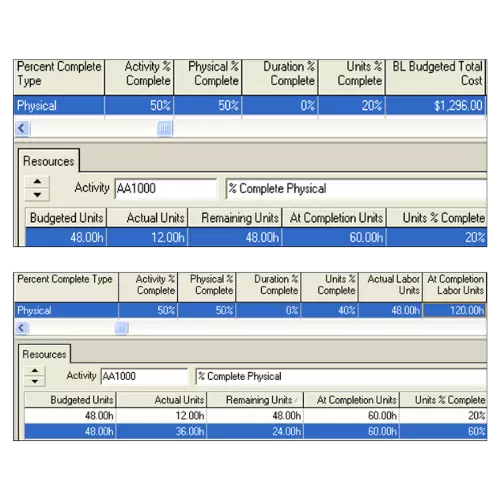

An activity assigned Physical Percent Complete Type may have the % Physical Complete entered in the Physical % Complete or the Activity % Complete. This field has no impact on schedule calculations and is not linked to either the Resource Units or the Actual and Remaining Durations of the Activity.
Physical % Complete must be used when Steps are being used to record progress.
The Physical Percent Complete type is often used when the progress of an Activity is being measured outside Primavera. For example, an activity representing the installation cable that is measured by length of cable installed would have the percent complete calculated by:
For example, the activity may only have the installation labor assigned to it, and therefore the installation labor parameter may not be used for the measurement of the Activity % Complete. In addition, because the percent complete of the activity is based on the length of cable installed, the Activity % Complete (the progress of the work) may be compared to the resource Units % Complete (the amount of labor used) which is calculated from the formula:
This example is demonstrated in the picture on the right:
After a second resource is added, the Activity Units % Complete of 40% is calculated from the addition of the two resource Actual Units and At Completion Units:

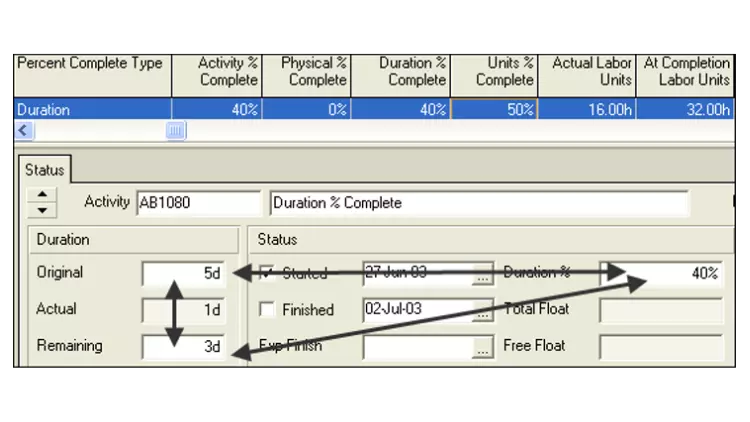

With Duration Percent Complete there is a link established between:
A Duration % Complete may only be entered after an Actual Start Date has been assigned and should be in the past with respect to the Current Data Date.
A change in one parameter will change one other:
The Actual Duration is calculated from the duration of Actual Start to the Current Data Date.

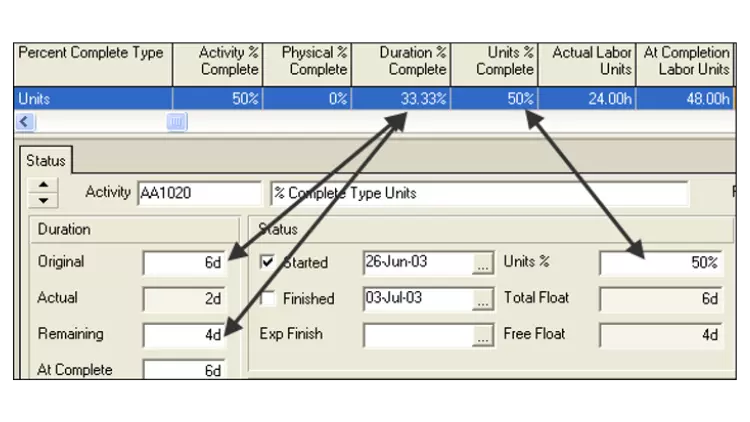

The Activity Units Percent Complete is still calculated from the Resource Units.

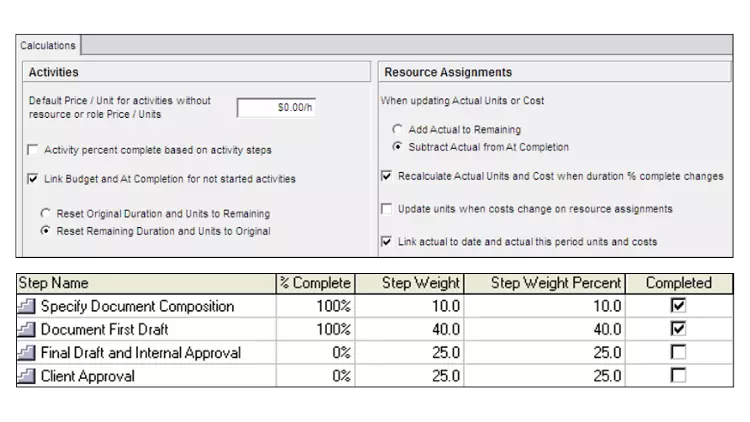

An activity Physical percent complete may be defined by using steps. A Step is a measurable or identifiable task required to complete an activity. Steps are useful to update activities that have many components, where the order of completion is not important but the measurement of progress is. Examples of the use of Steps:
In summary, to use steps:
Units Percent Complete may not be used when there are no resources assigned.
The major issue with Duration Percent Complete is that the Remaining Duration is linked to this value and it becomes hard to maintain Remaining Durations to round days which in turn makes activities start and finish at strange times and one day tasks span two days etc.
NOTE: This issue is overcome in products like Powerproject which has a function titles Snapping that keeps durations round irrespective of the percent complete value by rounding the Remaining Duration.
It is the author’s preference to use Physical % Complete:
If you want to learn more about Planning and Control with Microsoft Project, please check out my online course here.
