What are the issues with not updating a project schedule properly?
A properly updated schedule is very important if you wish to manage a project or substantiate delays with the schedule. It is very simple to update a Microsoft Project schedule incorrectly and end up with completed work in the future or incomplete work in the past, both of which are totally illogical.

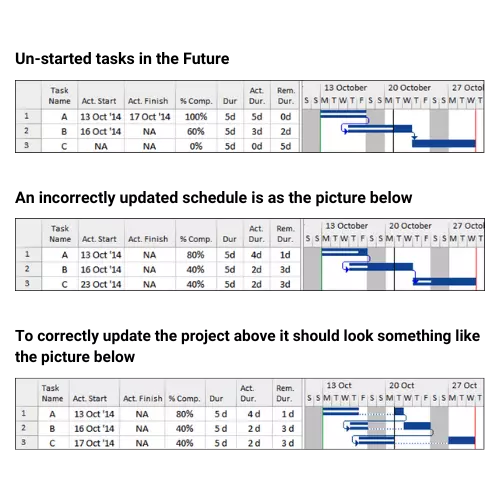

A correctly updated schedule should have, as the picture below:
This procedure is suited to people who wish to update a schedule properly and make sure the Actual dates and durations are correct. Updating your project this way complies with many documents published by organizations such as the AACE International Recommended Practices.

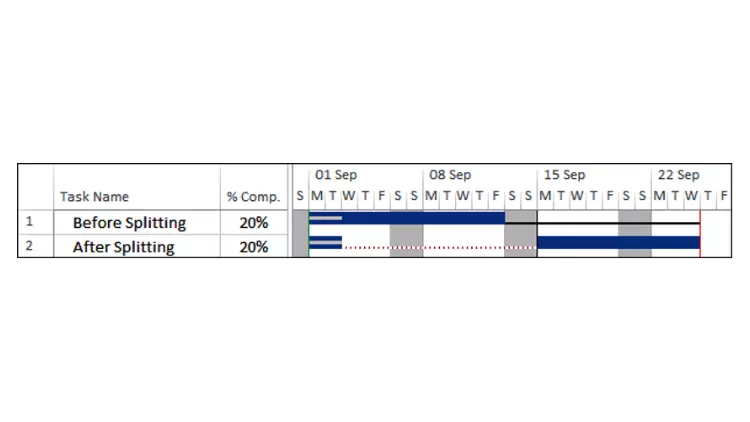

Tasks that are behind schedule may be split with the Reschedule Work button. This may be added to the Quick Access Toolbar or Ribbon or selecting Project, Status group, Update Project… to open the Update Project form and clicking on the Reschedule uncompleted work to start after: radio button.
Make sure that the File, Options, Schedule tab, Split in-progress tasks box is checked and you may wish to turn off Auto Calculation in the File, Options, Schedule, Calculation section before assigning an Actual Start as this will create a split at the start of the task when turned on and an Actual Start applied. You will then need to press F9 to reschedule after updating the tasks.
The Eastwood Harris template found at www.eh.com.au has much of this formatting completed and the Tracking Table has an additional column showing what is required to do to ensure the tasks are correctly updated.
Earn 25% commission when your network purchase Uplyrn courses or subscribe to our annual membership. It’s the best thing ever. Next to learning, of course.

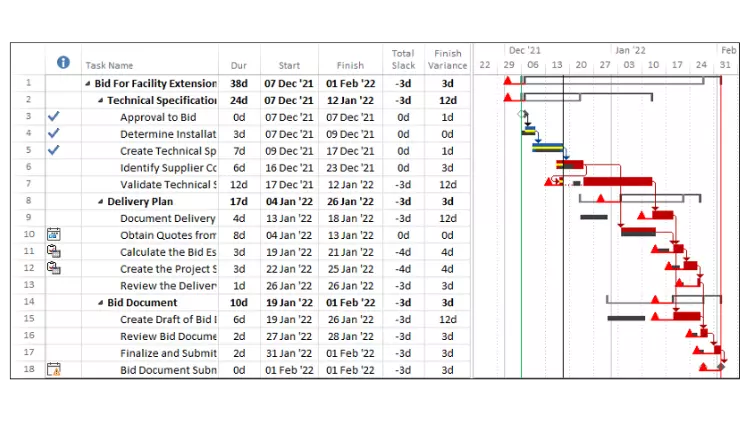

There will normally be changes to the schedule dates and more often than not there will be delays. The full extent of the change is not apparent without having a Baseline bar to compare with the updated schedule.
To display the Baseline Bar in the Gantt Chart you may use any of the functions covered in the FORMATTING THE DISPLAY chapter:
The following check list may be used to check an in-progress schedule.
Complete Tasks
In-Progress Tasks
Not Started Tasks
Open Ends and Total Float
Critical and Near Critical Path
Scope Changes
Performance
Baseline Comparison
There are two courses of action available with date slippage:
Solutions to return the project to its original completion date must be cleared with the person/people responsible for the project, since they can have the most impact on the work.
Suggested techniques to bring the project back on track include:
