Oracle released Primavera P6 Version 20 PPM for download from their web site late in 2020.
Oracle released a document that outlines all the changes from Version 19 to P6 Version 20 in a document titled Oracle Primavera P6 Cumulative Feature Overview P6 Professional 19.12 - 20.11 Release Feature Overview.
Oracle Primavera also has two Cumulative Feature Overview (CFO) tools for tracking changes in the P6 EPPM and PPM versions:
The aim of this document is to expand on the document published by Oracle and outline the changes a PPM user will see in the software and add some comments on the usability of the features including:
Earn 25% commission when your network purchase Uplyrn courses or subscribe to our annual membership. It’s the best thing ever. Next to learning, of course.

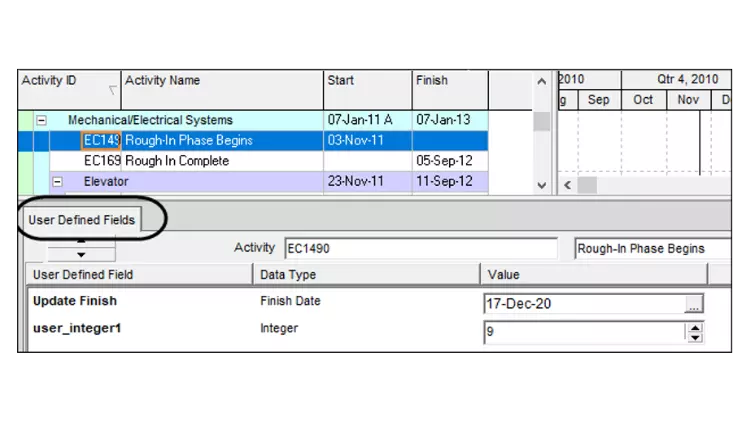

This function was introduced in Version 19 but so useful I have added it to this article. A User Defined Field Details tab is now available in many workspaces such as Projects, Resources, Activities and WBS. This is extremely useful as it allows users to see and assign UDFs without having to add extra columns to their Layouts.

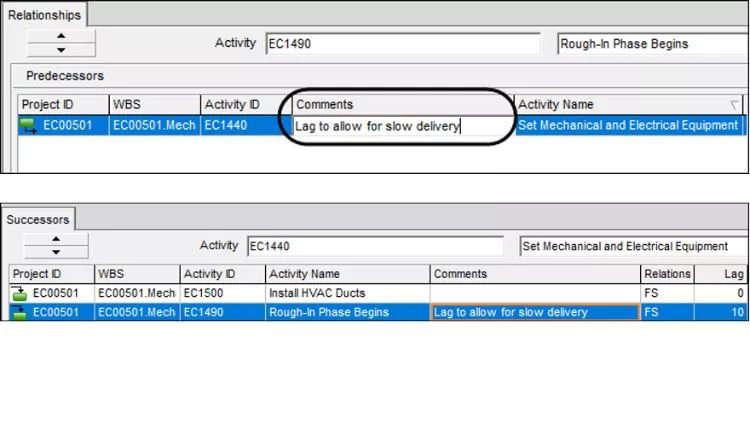

A Comments column may be added to the Activities window Relationships, Predecessor and Successor tabs.
The comment is seen in both the Predecessor and Successor window of each relationship assigned a comment.
This is a very useful function and in the past one had to either use a Note or a UDF assigned to either the predecessor or successor activity to record notes about a relationship. This function is also useful for recording changes to relationships. The Comments column is available in the Activity Relationship report.
Resources have always been able to vary their rate over time but Roles were not and this was one of the drivers to use resources and not roles on projects.
When an activity spans two periods then P6 calculates a proportional rate based on the activity duration in each period. You must use the Recalculate Cost Assignment function during or after rescheduling.

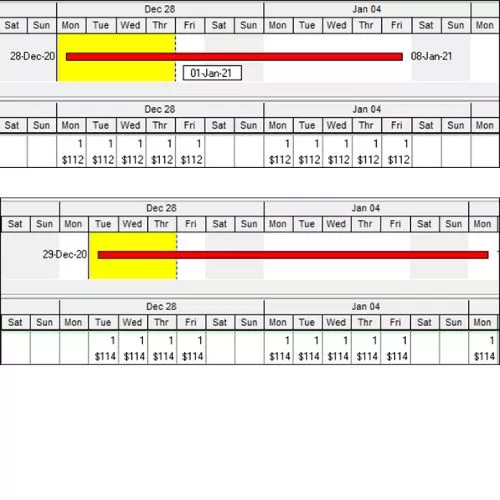

The pictures on the right show the result of assigning the Role Foreman above and has 4 days work in 2020 and 6 in 2021 and then 3 and 7 days. They demonstrate how the cost are calculated which are not entirely correct as the costs should be lower in 2021 and higher in 2022.

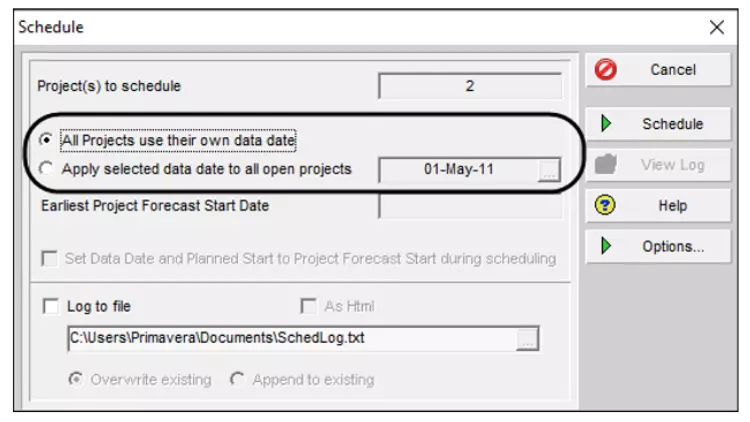

When scheduling multiple projects you now have a choice of the Data Date used for calculating:
Version 20 added the additional option of:

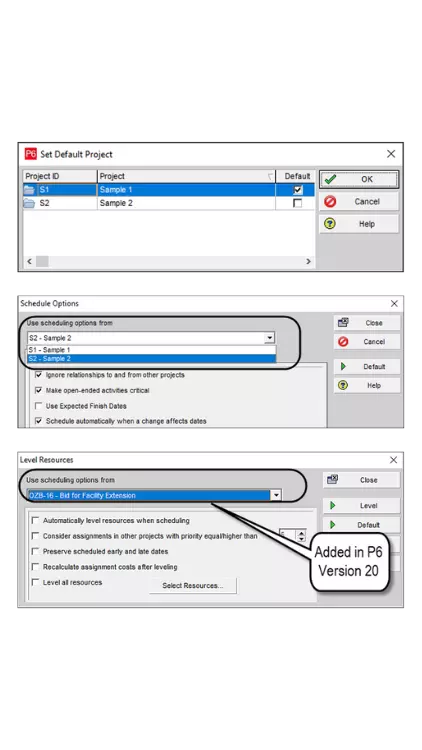

In the P6 Version 19 and earlier when multiple projects were scheduled together and they had different Scheduling Options, which could happen when users change them from default or when you imported a project, then all the different Scheduling Options of all the projects being scheduled were changed to the Default Project on a permanent basis and changed projects would calculate differently from then on.
The Default Project may still be set by selecting Project, Set Default Project.
But now you may select which project Scheduling Options are used when scheduling multiple project in the Scheduling Options form which is opened by selecting Tools, Schedule, Options.
The Default Project may also be selected in the Levelling form as well.
What happens now?
Thus, the problem of Scheduling Options being changed when scheduling multiple projects has NOT been solved. You now have two options to mess up your Scheduling Options of projects when scheduling multiple projects with different options.
Again, I reiterate you should make all the Scheduling Options in one database the same when you schedule multiple projects and be careful when importing projects.
Primavera Cloud allows activities to be broken down into tasks. Lean Tasks are similar to the P6 Steps function but with more functionality such as allowing the assignment of tasks to subcontractors. Lean Tasks may have the following attributes:
When you are using an EEPM database you may Import Lean Tasks through an XML file from Primavera Cloud.

You may now assign different Financial Period to projects in P6 Version 20 by the use of Financial Period Calendars. When you select Admin, Financial Period Calendars you may create multiple Financial Period Calendars and each may have different Financial Periods.
The Financial Period Calendar is assigned to a Project in:
Note: This function did not work in the authors P6 Version 20.12.0.37740, but updates should fix this issue. As an interim you may change the Default Financial Period Calendar before creating a project.

There is a new function titled Assignment Codes allowing users to code up assignments so resource assignments may be Grouped or Filtered. This function could be used for:
Assignment Codes are created in the same way as other codes by selecting Enterprise, Assignment Codes.
Assignment Codes are assigned to Resource or Role Assignments in the:
Resource Assignment Window now allows Grouping and Filtering by Codes and UDFs
Data in the Resource Assignment window may be filtered and/or grouped using Project, Activity and WBS User Defined Fields (UDFs) and Project Codes in P6 Version 20.
Fill down available in Activities Window Resource Usage Spreadsheet
Fill down is available in the Activities Window Resource Usage Spreadsheet in P6 Version 20.
P6 Continues Working when there is a Network Failure
Users may continue working is some circumstances when connected to an EPPM Cloud Connect database and configured to allow this when there is a network failure.
Prevent Risk Categories being Imported into a PPM Database
When exporting to an XER file Risk Categories are exported but in P6 Version 20 you are able to prevent the Categories being imported into a PPM or SQLite database.
Arabic Language
Arabic is supported in P6 Version 20.
Reset Locked Users
In the EPPM version users locked out of P6 or Visualizer may be reset.
Uploading of Harmful Files

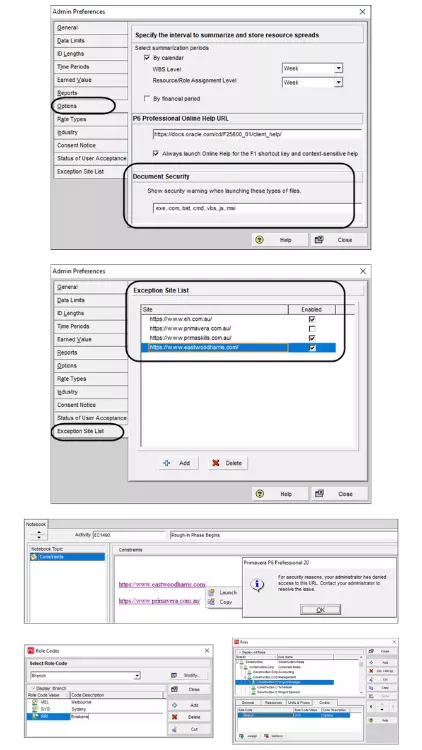

You may prevent people from uploading harmful files in the Admin Preferences, Options, Document Security.
Exception Site List
A list of web sites may be added to Admin Preferences, Options, Exception Site List.
The URLs may then be added to Notebook Topics and UDFs and permitted URLs may be launched from P6 by clicking on the URL and selecting Launch.
URLs not listed or not permitted may not be launched but may be copied and pasted into a browser. The picture below demonstrates what happens when a URL that has not been enabled has been selected for Launching.
Role Codes
P6 Version 20 introduced Role Codes allowing Roles to be assigned Code in the same way as Resources and Activities. This would be useful to assign attributes such as location or office and may be used to group or filter roles.
If you want to learn more about Planning and Control with Microsoft Project, please check out my online course here.
